Visits in the calendar: actual time, progress and colors

A visit is one time slot booked in the calendar for a work order. Visits used to have statuses of their own ("Not started", "In progress", "Finished", "Unfinished"). They no longer do. Instead, a visit records its actual time: when the work really started and when it really ended. Those two times decide how the visit looks in the calendar, while the progress of the whole job, including whether it is done or still needs more work, is shown by the work order's status.

This guide covers how to tell planned, running and ended visits apart, where the actual time comes from and how to correct it from the office, what decides a visit's color in the calendar, and where to read the notes technicians leave about a visit. Throughout, "the office" means anyone who works in the ServisGo dashboard: you, your dispatchers and your managers.

On this page
  1. Planned, running, ended: the three states of a visit
  2. Actual time: when the work really happened
  3. Correcting the actual time from the office
  4. What the actual time changes, and what it does not
  5. What decides a visit's color in the calendar
  6. Worker notes: what the technician wants the office to know

Planned, running, ended: the three states of a visit

In the sidebar on the left, click "Calendar". For a close look at one day, click "Day" in the top-right corner of the calendar, next to "Month" and "Week". Each technician has a column, and every visit is a block in that column. The screenshot shows today in the day view, with the columns of two technicians, James Miller and Daniel Brown, and three visits, each in a different state.

The calendar day view with the columns of James Miller and Daniel Brown: an orange visit for Oliver Bennett with a check-mark badge in its corner, a green visit for Amelia Clarke and a blue visit for Harry Foster, numbered 1 to 3
The numbers mark an ended visit with its check-mark badge (1), a running visit (2) and a planned visit (3).
  1. An ended visit: Oliver Bennett, "Boiler maintenance", 08:00 to 09:00, in James Miller's column. The small round white badge with a green check mark in the block's top-right corner shows that the work has ended. The block is orange because its work order is "Completed".
  2. A running visit: Amelia Clarke, "AC installation", 13:00 to 15:00, in Daniel Brown's column. It has no badge. On screen the block gently pulses, which a still picture cannot show. It is green because its work order is "In Progress".
  3. A planned visit: Harry Foster, "Water leak repair", 15:30 to 17:00, later the same day in James Miller's column. It has no mark at all. It is blue because its work order is "Scheduled".

Every block shows the work order's number and the client's name, then the address and the service. The dark strip along the top of a block is the travel time to that address.

Nobody sets a visit's state by hand. ServisGo works it out from the visit's actual time:

Planned
No actual start has been recorded yet. The block has no mark at all.
Running
The visit has an actual start and no actual end, so a technician is working there right now. The block gently pulses: a soft ring around it and a slight brightening come and go.
Ended
The visit has an actual end. The block carries a small round white badge with a green check mark in its top-right corner; point at the badge and a hint reads "Visit ended". In the month view, where a visit is a single line, a small check mark sits in front of the visit's title instead.

The same marks follow a visit into its work order. In the sidebar, click "Work Orders", then click the work order's number in the "ID" column. The "Work Order" dialog opens. Its "Scheduling" card, at the bottom of the wide left column, lists the visits one per row.

The Scheduling card of Charlotte Hughes's work order with two visit rows, the first with a check mark in front of its date and the second without, and the planning window in the card's top-right corner
The check mark in front of the first row's date marks an ended visit, and the second row, without a mark, is still planned. The work order was opened by clicking its number in the "ID" column.

This is Charlotte Hughes's work order, a job with two visits. The first row has a check mark in front of its date: that visit ended last week. The second row has nothing in front of it: that visit is planned for later this week. A running visit has an amber "In progress" label in the same spot. If the work order has a planning window (the dates the job was meant to fit into), it is shown in the card's top-right corner, next to the label "Planning window".

You will see the same three states in two more places:

  • The work orders list. In the sidebar, click "Work Orders" and look at the "Scheduled" column. It shows every visit of a work order as a dark tag with the day, the time and the technician. A check mark in front of the day means the visit has ended, an amber dot means it is running, and no mark means it is planned.
  • The technician app. Your technicians see the same three states as a label on the visit: a blue "Not started", an amber "In progress" or a green "Ended".

Actual time: when the work really happened

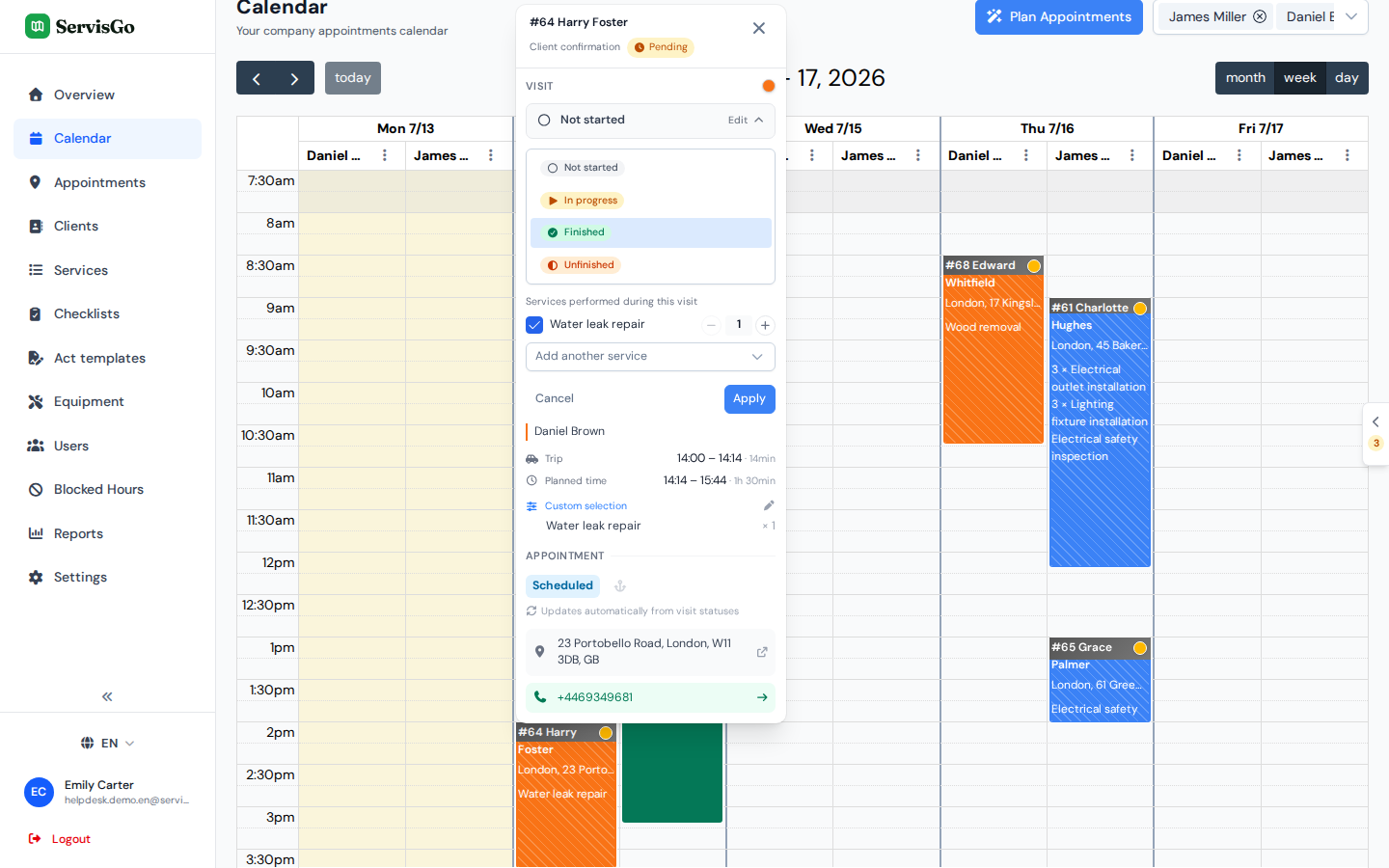

In the sidebar, click "Calendar", then click a visit block once. A small window opens next to the block, and its "Actual time" row holds two times of day, both on the visit's planned day: when the work really started and when it really ended. The row sits right under "Planned time", so one glance is enough to compare the plan with what really happened. The screenshot shows the upper part of that window for Oliver Bennett's visit, the one that ended this morning.

The upper part of the visit window for Oliver Bennett: the header with the client, phone number and address, the Completed status badge, the round color dot, and the Trip, Planned time and Actual time rows, with marks 1 to 4
Opened by clicking the visit block: the numbers mark the status badge (1), the color dot (2), "Planned time" (3) and "Actual time" (4).

The header at the top of the window, above the marks, holds the work order's number and the client's name, then the phone number and the address. The X in its top-right corner closes the window.

  1. The work order's status badge with a small arrow, here "Completed". It shows the status of the whole job, not of this one visit. Click it to open the menu for closing the job; the work order statuses guide explains every choice in it.
  2. The round color dot, at the right end of the same row. It shows the visit's color. Click it to give this one visit a color of its own, as described under "What decides a visit's color in the calendar" below.
  3. "Planned time": the booked slot and its length. Here it is 08:00 to 09:00, "1h".
  4. "Actual time": the real start, the real end and how long the work took. Here it is 08:03 to 08:58, "55min", against a plan of 08:00 to 09:00.

The unmarked "Trip" row, between the badge and "Planned time", is the planned drive to the address.

What the "Actual time" row shows depends on how far the visit has come:

  • A dash while nothing is recorded. The visit is still planned.
  • The start followed by "running now" in amber while the visit is running.
  • The start and the end, followed by the duration, once the visit has ended.

Click a running visit in the calendar, such as Amelia Clarke's, and the window shows the middle case: the visit started at 13:04 and is still going.

The upper part of the visit window for Amelia Clarke: the In Progress status badge, Planned time 13:00 to 15:00 and Actual time 13:04 followed by running now in amber
Opened by clicking the running visit: "Actual time" shows the 13:04 start followed by "running now".

Who records the actual time

Normally nobody types anything: the technician's own taps record both times. In the technician app, tapping "Start work" on the visit records the start at that very minute. When the work is done, the technician taps "Finish work" and then "End visit" at the bottom of the form that opens, and that records the end. For more about the app, see the technician app guide.

  • The first tap counts. If the technician later reopens an ended visit with "Correct details" to fix what was entered, neither time moves.
  • The start and the end are plain times of day, in hours and minutes, and both belong to the visit's planned day: the actual time carries no date of its own. So a forgotten visit never ends on the wrong day. When a technician forgets to end a visit and does it on a later day, the end is recorded as the visit's planned end time. If the real end was different, correct it from the office as described in the next section.
  • The end is never earlier than the start.

Correcting the actual time from the office

Sometimes the office has to step in: the technician forgot to tap "Start work" or to end the visit, tapped late, works without the app, or you are entering the day's times afterwards from a paper timesheet. You can set or correct the times in two places: straight in the calendar, or in the work order form.

In the calendar

  1. 1
    Open the calendar

    In the sidebar on the left, click "Calendar". Use the arrow buttons in the top-left corner of the calendar to get to the day of the visit.

  2. 2
    Click the visit

    Click the visit block once. A small window opens next to it, with the "Actual time" row right under "Planned time".

  3. 3
    Click the time itself

    Look at the right end of the "Actual time" row: it shows the times, or a dash if nothing is recorded yet. Point at it and a hint reads "Change the actual time". Click it, and it turns into two small fields: "at" for the start and "to" for the end.

    The visit window for Oliver Bennett with the Actual time row turned into two small fields, at 8:03 and to 8:58
    After a click on the actual time, the row holds two fields: "at" for the start and "to" for the end.
  4. 4
    Type the start and the end

    Type both times with a colon, for example 8:03 into "at" and 8:58 into "to". The colon matters: a number with a dot is read as hours, so 8.5 is saved as 08:30.

  5. 5
    Press Enter

    Press Enter, or click anywhere outside the two fields. The time is saved at once: there is no save button, and a short "Actual time saved" message confirms it. To leave the fields without changing anything, press Esc instead.

A few rules apply to what you type:

  • The end must be later than the start. Otherwise the field turns red and nothing is saved.
  • An end without a start is refused the same way.
  • A start on its own is fine. It means the visit is running, so the row shows "running now" and the block pulses in the calendar.
  • Emptying both fields clears the actual time, and the visit looks planned again.

Once the office has typed or changed a time, a small icon of a person with a pencil appears in front of the time. Point at it and it says "Entered by the office", so you can always tell an office entry from the technician's own taps. The icon disappears when the office clears both times.

For the work order's status, a start typed by the office counts exactly like the technician's own tap: a started visit turns the work order "In Progress", even before its planned time. Clear the start, and the status follows the planned times again. See the work order statuses guide.

In the work order

The same "Actual time" row is in the work order form, which is handy when you are editing the work order anyway.

  1. 1
    Open "Work Orders"

    In the sidebar on the left, click "Work Orders".

  2. 2
    Open the work order for editing

    Find the work order in the list, click the three-dot button at the end of its row and pick "Edit". The "Update Work Order" dialog opens.

  3. 3
    Expand the visit

    Scroll down to the "Scheduling" section at the bottom of the form, where the visits are listed one per row. Click "Edit" near the right end of a visit's row. The row expands and shows "Actual time". Leave the X after "Edit" alone: it removes the visit.

  4. 4
    Change the time

    Click the time (or the dash), type the start into "at" and the end into "to", and press Enter, just as in the calendar. The same rules apply. The visit's row gets an amber "Edited" tag.

  5. 5
    Click "Update"

    Here the time is saved together with the rest of the form: click "Update" in the bottom-right corner of the dialog. The form closes, a short "Work order was successfully updated." message appears and the work order opens for viewing. If you close the form with "Cancel", in the bottom-left corner, the change is dropped.

When you only view a work order (click its number in the "ID" column of the "Work Orders" list), each visit's row in the "Scheduling" card ends with "View" instead of "Edit". Click it and the row expands, showing the actual time as plain text that cannot be changed there.

What the actual time changes, and what it does not

The actual time is a record of what happened. Here is what follows from it, and what does not:

  • It decides how the visit looks: planned, running or ended. It plays no part in planning.
  • The work order's status is worked out from whether its visits are still ahead or already behind, and that is always judged by a visit's planned time, never by its actual time. "Ahead" means the planned time has not come yet. "Behind" means only that it has passed, not that anyone is running late. A visit planned for yesterday is behind even if nobody ever started it. A visit planned for tomorrow is ahead even if the office has already typed actual times into it.
  • A visit that is running keeps its work order "In Progress". The work order statuses guide explains how that status is worked out.
  • When the office marks a work order "Finished" or "Cancelled", a visit that is still running is ended automatically. With "Mark as completed", the choice is yours: the dialog has an "End the visits in progress" checkbox, ticked by default.

One safeguard is built in: nothing automatic ever removes or moves a visit that has an actual start. That holds in each of these cases:

  • You close a work order with "Unschedule upcoming visits" ticked. That checkbox is in the dialog you confirm when closing a work order; see the work order statuses guide.
  • You unschedule several work orders at once: you tick them in the "Work Orders" list, click "Actions" in the bar that appears above the table and pick "Unschedule".
  • A visit dropped into the calendar pushes the visits after it later. That happens when "Push overlapping visits" is switched on in the menu behind the cog button in the top-right corner of the calendar.
  • Automatic planning ("Plan automatically") books visits for you.

In every one of them a started visit stays where it is, until a person moves or unschedules it by hand.

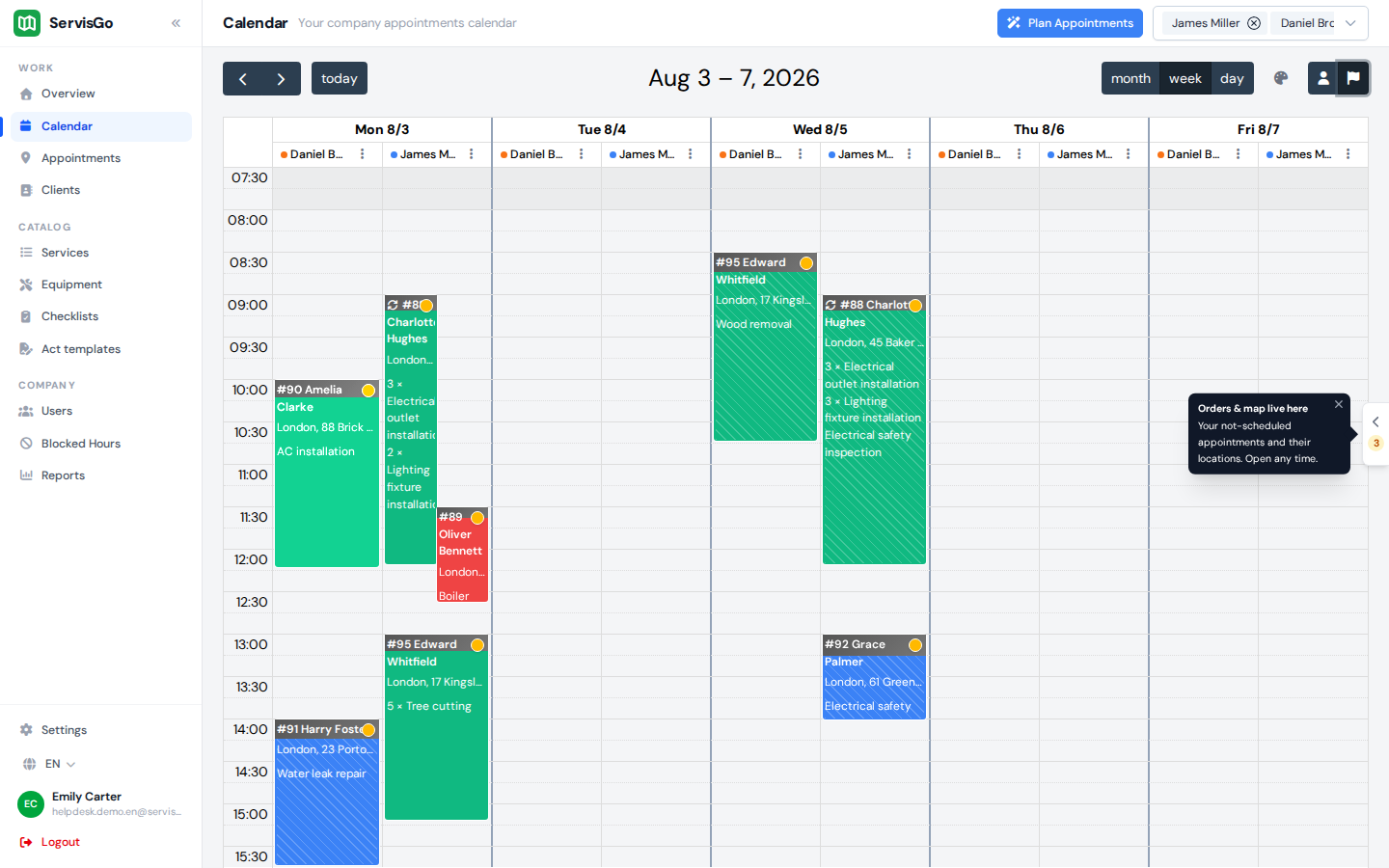

What decides a visit's color in the calendar

In the sidebar, click "Calendar". Every visit block is filled with the color of its work order's status. All visits of one job therefore share a color, and the calendar answers one question at a glance: how far along is each job?

Scheduled
Blue. The job is booked and the work has not started.
In Progress
Green. A blue visit turns green on its own when the planned start of the job's first visit arrives.
On Hold
Red. A visit turns red once the planned time of every visit of the job has passed and nobody has closed the job.
Completed
Orange. A visit turns orange when the job is marked completed.
Finished
Dark green, shown faded. The job is done and everything is settled.
Cancelled
Pink, shown faded. The job was called off.

The color changes on its own as the status changes, so there is nothing to recolor by hand. A "Not Scheduled" work order has no visits, which is why its color never appears in the calendar. What each status means and how a job is closed are covered in the work order statuses guide.

Faded means half transparent: visits of "Finished" and "Cancelled" work orders fade into the background, so the open jobs stand out.

You can tell which technician a visit belongs to by its column, not by its color. Each technician also has a colored dot next to their name in the column header (blue for James Miller and orange for Daniel Brown in the screenshot at the top of this guide), and the same dot appears in every visit tag, for instance in the "Scheduled" column of the work orders list. The blocks themselves are not colored by technician, and the two coloring buttons that used to sit in the calendar's toolbar are gone.

Giving one visit its own color

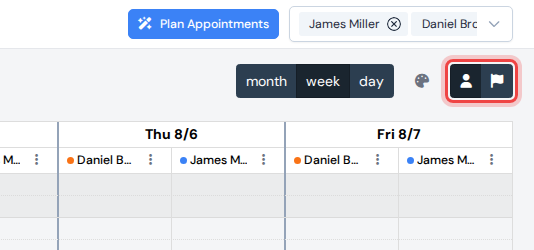

Sometimes one visit has to stand out whatever its status, for example a visit that is waiting for a delivery. Give it a color of its own:

  1. 1
    Open the visit window

    In the sidebar, click "Calendar", then click the visit block once. The small window opens next to it.

  2. 2
    Click the round color dot

    The dot sits at the right end of the row with the status badge; it is mark 2 in the screenshot under "Actual time: when the work really happened" above. Point at it and a hint reads "Set slot color". Click it, and a row of round color swatches opens under it.

  3. 3
    Pick a color

    Click one of the swatches. The visit takes that color at once and the row of swatches closes; there is nothing else to save. For any other shade, click the last button in the row, the round gray one with a palette icon ("Custom color"). A color picker opens under the swatches: choose the shade and confirm with "Apply", under the picker on the right. "Cancel", on the left, closes the picker and the swatches without changing the color; click the color dot again to bring them back.

From then on the visit keeps its color whatever the status of its work order. To undo it, click the color dot again: once a visit has a color of its own, a "Reset to default" link appears under the swatches, and clicking it gives the visit its status color back.

A small violet badge with a magic wand in a block's corner is not about status or color. It means the visit was placed by automatic planning; point at it and it says "Planned automatically".

Worker notes: what the technician wants the office to know

A technician can leave a note about each visit. In the technician app, tapping a visit opens its page, which has a "Worker notes" field with the hint "What should the office know about this visit?". The technician types the note and taps "Save" under the field. The same field comes up again in the form that ends the visit, where the note is saved together with the rest of the form. There is one note per visit, and the technician can change it later in the same way.

To read the notes at the office, click "Work Orders" in the sidebar, then click the work order's number in the "ID" column. The "Work Order" dialog opens, and the "Notes" card is in its right-hand column.

The Notes card of Charlotte Hughes's work order: the office note about the apartment renovation on top, then Worker notes with the tag of the first visit and James Miller's note about a missing bracket under it
The "Notes" card, opened by clicking the work order's number in the "ID" column: the office's note on top, the technician's note under "Worker notes".

On top is the office's own note for the work order, here "Apartment renovation: outlets and lighting in two stages, inspection at the end." Below the thin dividing line comes the heading "Worker notes". This work order has two visits, so the note sits under the tag of the visit it belongs to, and the tag shows the day, the time and the technician. On the first visit, James Miller wrote: "One light fitting came without its bracket. I will fit it on the next visit." When a work order has a single visit, only the text is shown, without a tag.

  • Worker notes are read-only in the dashboard. They are written and changed by the technician, in the app.
  • The "Notes" card appears only when there is something in it. A work order with neither an office note nor a worker note has no such card.
  • The office's own note is edited in the work order form, as before: in the "Work Orders" list, click the three-dot button at the end of the work order's row, pick "Edit", change the text in the "Notes" card and click "Update".
  • Older remarks that technicians wrote as comments, before worker notes existed, are not lost. They stay in the work order's history: click the work order's number in the "ID" column of the "Work Orders" list and look for the "Activity" card, the last one in the right-hand column. The card is collapsed at first, so click its heading to expand it.
